JavaScript/jQuery Gantt - validation

Configures validation properties.

Type:

Object

View Demo

jQuery
index.js
$(function() {
    $("#gantt").dxGantt({
        validation: {
            autoUpdateParentTasks: true,
            validateDependencies: true
        },
        // ...
    });
});
Angular
app.component.html
app.component.ts
app.module.ts
<dx-gantt ... >
    <dxo-gantt-validation
        [autoUpdateParentTasks]="true"
        [validateDependencies]="true">
    </dxo-gantt-validation>
    <!-- ... -->
</dx-gantt>
import { Component } from '@angular/core';

@Component({
    selector: 'app-root',
    templateUrl: './app.component.html',
    styleUrls: ['./app.component.css']
})

export class AppComponent {
    // ...
}
import { BrowserModule } from '@angular/platform-browser';
import { NgModule } from '@angular/core';
import { AppComponent } from './app.component';
import { DxGanttModule } from 'devextreme-angular';

@NgModule({
    imports: [
        BrowserModule,
        DxGanttModule
    ],
    declarations: [AppComponent],
    bootstrap: [AppComponent]
})
export class AppModule { }
Vue
App.vue
<template>
    <DxGantt ... >
        <DxValidation
            :auto-update-parent-tasks="true"
            :validate-dependencies="true"
         />
        <!-- ... -->
    </DxGantt>
</template>
<script>
    import 'devextreme/dist/css/dx.fluent.blue.light.css';
    import 'devexpress-gantt/dist/dx-gantt.css';

    import {
        DxGantt,
        DxValidation,
        // ...
    } from 'devextreme-vue/gantt';

    export default {
        components: {
            DxGantt,
            DxValidation,
            // ...
        }
    };
</script>
React
App.js
import React from 'react';

import 'devextreme/dist/css/dx.fluent.blue.light.css';
import 'devexpress-gantt/dist/dx-gantt.css';

import Gantt, {
    Validation,
    // ...
} from 'devextreme-react/gantt';

const App = () => {
    return (
        <Gantt ... >
            <Validation
                autoUpdateParentTasks={true}
                validateDependencies={true} />
            {/* ... */}
        </Gantt>
    );
};

export default App;
ASP.NET Core Controls
Razor C#
@(Html.DevExtreme().Gantt()
    .Validation(e => {
        e.AutoUpdateParentTasks(true);
        e.ValidateDependencies(true);
    })
    // ...
)
ASP.NET MVC Controls
Razor C#
@(Html.DevExtreme().Gantt()
    .Validation(e => {
        e.AutoUpdateParentTasks(true);
        e.ValidateDependencies(true);
    })
    // ...
)

autoUpdateParentTasks

Specifies whether to recalculate the parent task's duration and progress when its child tasks are modified.

Type:

Boolean

Default Value: false

The Gantt uses the following rules to determine whether to update a parent task when its subtask is modified.

  • A parent task's duration equals a summary duration of its child tasks.
  • A parent task and its first child starts at the same time.
  • A parent task and its last child ends at the same time.
  • A parent task's progress is a summary progress of its child tasks.

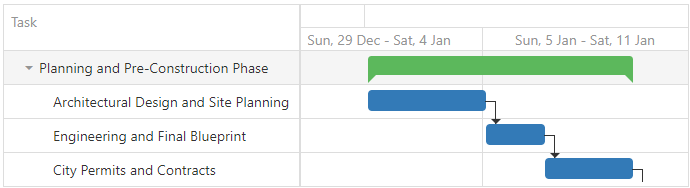

DevExtreme Gantt - Parent and Child Tasks Validation

enablePredecessorGap

Specifies whether users can move or resize a predecessor to change a gap before a successor according to the dependency rules.

Type:

Boolean

Default Value: false

The Gantt component allows users to change the gap between tasks only if they move/resize a successor task. Note that users can use only a successor to create the gap between tasks.

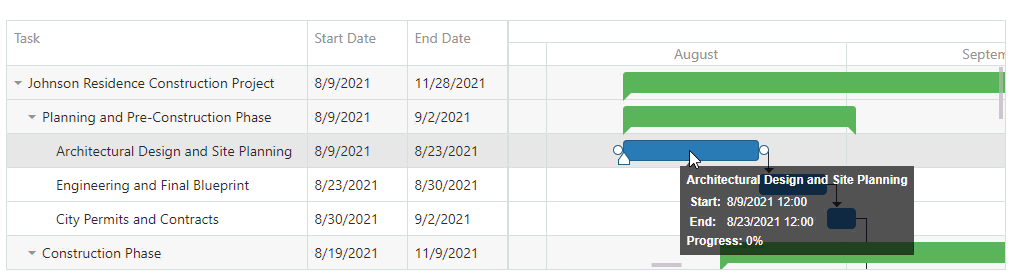

The following image illustrates that the Gantt does not resize the gap between tasks when users move the predecessor:

DevExtreme Gantt - Move Successor to Change Gap

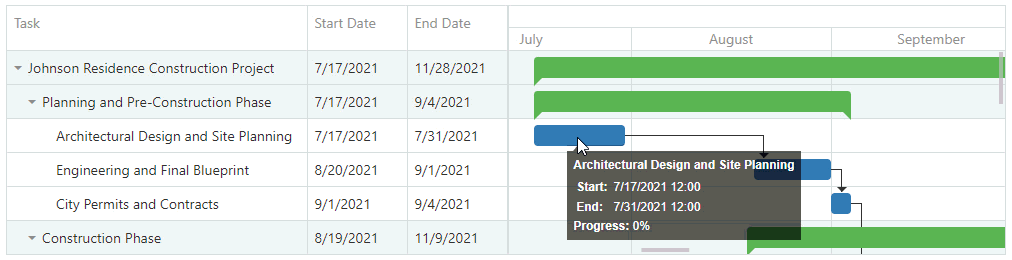

The enablePredecessorGap option allows users to increase/decrease the gap between the tasks with a predecessor. The Gantt component validates these changes and shifts the successor task to comply with the dependency rules if they are violated.

DevExtreme Gantt - Move Successor to Change Gap

NOTE
The enablePredecessorGap option is in effect if the validateDependencies option is set to true.
jQuery
index.js
$(function() {
    $("#gantt").dxGantt({
        validation: {
            validateDependencies: true,
            enablePredecessorGap: true
        },
        // ...
    });
});
Angular
app.component.html
app.component.ts
app.module.ts
<dx-gantt ... >
    <dxo-gantt-validation
        [enablePredecessorGap]="true"
        [validateDependencies]="true">
    </dxo-gantt-validation>
    <!-- ... -->
</dx-gantt>
import { Component } from '@angular/core';

@Component({
    selector: 'app-root',
    templateUrl: './app.component.html',
    styleUrls: ['./app.component.css']
})

export class AppComponent {
    // ...
}
import { BrowserModule } from '@angular/platform-browser';
import { NgModule } from '@angular/core';
import { AppComponent } from './app.component';
import { DxGanttModule } from 'devextreme-angular';

@NgModule({
    imports: [
        BrowserModule,
        DxGanttModule
    ],
    declarations: [AppComponent],
    bootstrap: [AppComponent]
})
export class AppModule { }
Vue
App.vue
<template>
    <DxGantt ... >
        <DxValidation
            :enable-predecessor-gap="true"
            :validate-dependencies="true"
         />
        <!-- ... -->
    </DxGantt>
</template>
<script>
    import 'devextreme/dist/css/dx.fluent.blue.light.css';
    import 'devexpress-gantt/dist/dx-gantt.css';

    import {
        DxGantt,
        DxValidation,
        // ...
    } from 'devextreme-vue/gantt';

    export default {
        components: {
            DxGantt,
            DxValidation,
            // ...
        }
    };
</script>
React
App.js
import React from 'react';

import 'devextreme/dist/css/dx.fluent.blue.light.css';
import 'devexpress-gantt/dist/dx-gantt.css';

import Gantt, {
    Validation,
    // ...
} from 'devextreme-react/gantt';

const App = () => {
    return (
        <Gantt ... >
            <Validation
                enablePredecessorGap={true}
                validateDependencies={true} />
            {/* ... */}
        </Gantt>
    );
};

export default App;
ASP.NET Core Controls
Razor C#
@(Html.DevExtreme().Gantt()
    .Validation(e => {
        e.EnablePredecessorGap(true);
        e.ValidateDependencies(true);
    })
    // ...
)
ASP.NET MVC Controls
Razor C#
@(Html.DevExtreme().Gantt()
    .Validation(e => {
        e.EnablePredecessorGap(true);
        e.ValidateDependencies(true);
    })
    // ...
)

validateDependencies

Enables task dependencies validation.

Type:

Boolean

Default Value: false

The Gantt supports the following dependency validation rules:

  • Finish to Start (FS) - A successor task's start point should be equal or later than the preceding task's end point.
  • Start to Start (SS) - A successor task's start point should be equal or later than the preceding task's start point.
  • Finish to Finish (FF) - A successor task's end point should be equal or later than the preceding task's end point.
  • Start to Finish (SF) - A successor task's end point should be equal or later than a preceding task's start point.

The Gantt allows you to validate relationships between tasks when they are edited.

User Action Dependency Type Gantt's Reaction
Move a predecessor task (Task 1) to the left or right. Finish to Start (FS):
DevExtreme Gantt - Dependency validation - Finish To Start
Start to Start (SS):
DevExtreme Gantt - Dependency validation - Start To Start
Start to Finish (SF):
DevExtreme Gantt - Dependency validation - Start To Finish
Finish to Finish (FF):
DevExtreme Gantt - Dependency validation - Finish To Finish
The UI component moves a successor task (Task 2) forward or backward to the same time interval.
Move a successor task (Task 2) to the left. Finish to Start (FS):
DevExtreme Gantt - Dependency validation - Finish To Start
Start to Start (SS):
DevExtreme Gantt - Dependency validation - Start To Start
Start to Finish (SF):
DevExtreme Gantt - Dependency validation - Start To Finish
Finish to Finish (FF):
DevExtreme Gantt - Dependency validation - Finish To Finish
This change is denied as it violates dependency rules.

The control displays a popup window and suggests the following actions:
  • Cancel the operation.
  • Delete the dependency.
Move a successor task (Task 2) to the right. Finish to Start (FS):
DevExtreme Gantt - Dependency validation - Finish To Start
Start to Start (SS):
DevExtreme Gantt - Dependency validation - Start To Start
Start to Finish (SF):
DevExtreme Gantt - Dependency validation - Start To Finish
Finish to Finish (FF):
DevExtreme Gantt - Dependency validation - Finish To Finish
The control displays a popup window and suggests the following actions:
  • Cancel the operation.
  • Delete the dependency.
  • Move the task and keep the dependency. It creates a gap between tasks. Note that you can move tasks forward and backward within this gap while it meets the dependency rules.
